Adobe Workfront determines the Progress Status of a project by looking at the progression of the project across its timeline. You can configure Workfront to determine the Condition of a project based on the value of the Progress Status of the tasks. For more information about configuring the Condition of the project, see the article Overview of Project Condition and Condition Type.
The following are the Progress Statuses of projects in Workfront:

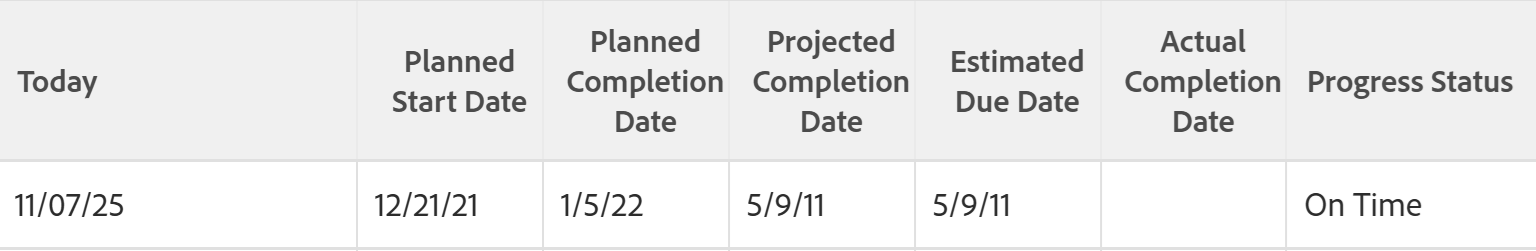

On Time | If both Projected and Estimated Completion Dates are earlier than or equal to the project's Planned Completion Date, the Progress Status of the project is On Time. |

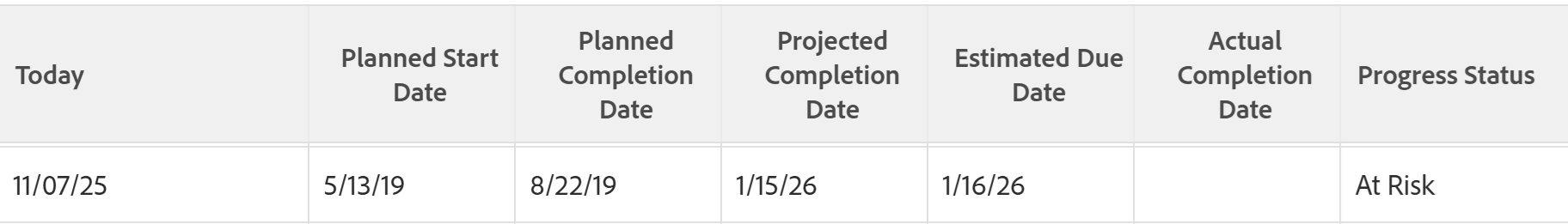

At Risk | When both the Estimated and Projected Completion Dates are in the future but later than the Planned Completion Date of the project and the Estimated Completion Date is later than the Projected Completion Date, the project Progress Status is At Risk. |

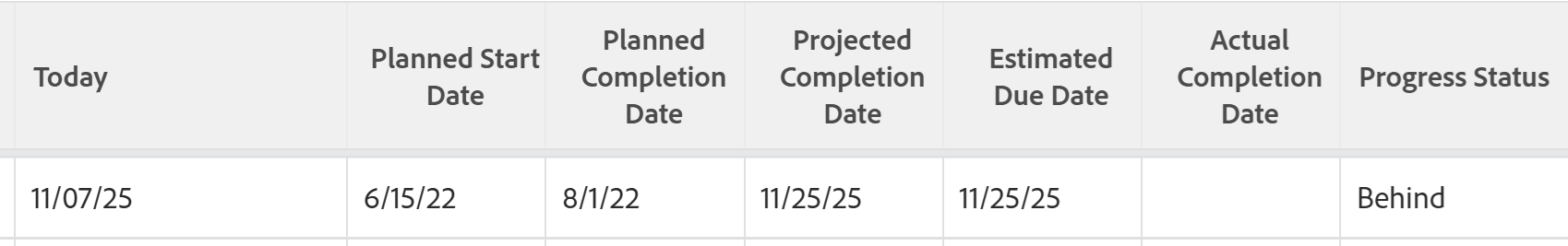

Behind | When both the Estimated and Projected Completion Dates are in the future but later than the Planned Completion Date of the project, but the Estimated Completion Date is not later than Projected Completion Date, the project Progress Status is Behind. |

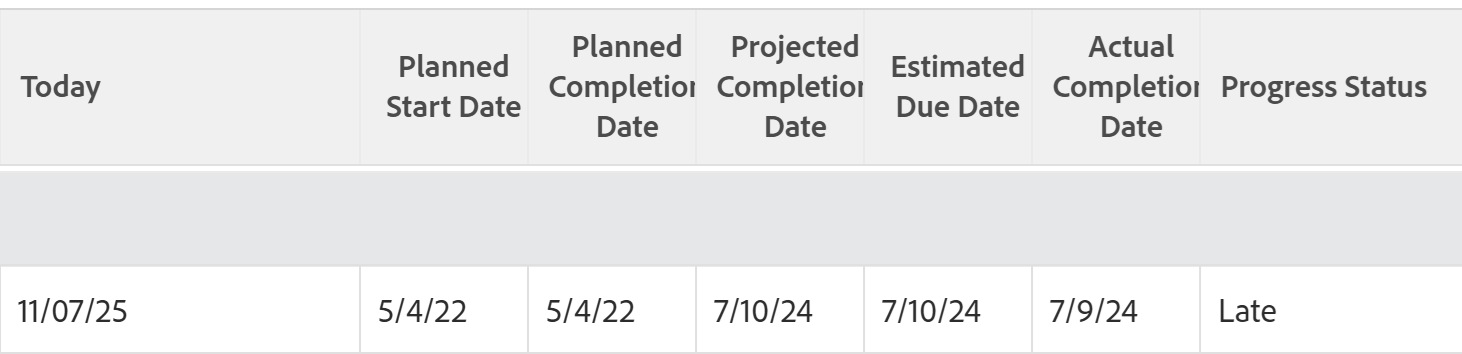

Late |
|
Consider the following:
For information about the project Critical Path, see Overview of the project Critical Path.
For information about Projected Completion Dates, see Overview of the Projected Completion Date for projects, tasks, and issues.
