View: Actual Hours over Planned Hours in the same column of a task View
In this task view, the actual amount of hours recorded on a task are displayed over the hours planned for each task. The Hours Variance between the Planned and the Actual Hours also displays in a separate column.
Access requirements
You must have the following access to perform the steps in this article:
table 0-row-2 1-row-2 2-row-2 3-row-2 layout-auto html-authored no-header | |
---|---|
Adobe Workfront plan | Any |
Adobe Workfront license* |
New:
Current:
|
Access level configurations |
Edit access to Reports, Dashboards, Calendars to modify a report Edit access to Filters, Views, Groupings to modify a filter |
Object permissions | Manage permissions to a report |
*For information, see Access requirements in Workfront documentation.

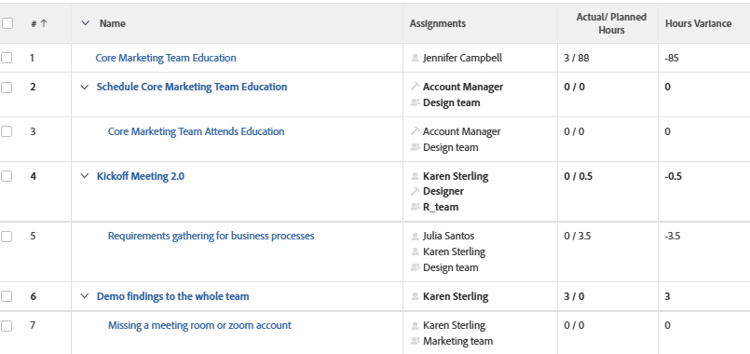

View Actual Hours over Planned Hours in a task view
To apply this view:
-
Go to a list of tasks.
-
From the View drop-down menu, select New View.
-
In the Column Preview area, eliminate all columns except for one.
-
Click the header of the remaining column, then click Switch to Text Mode.
-
Mouse over the text mode area, and click Edit Text Mode.
-
Remove the text you find in the text mode box, and replace it with the following code:
code language-none column.0.descriptionkey=name column.0.link.linkproperty.0.name=ID column.0.link.linkproperty.0.valuefield=ID column.0.link.linkproperty.0.valueformat=int column.0.link.lookup=link.view column.0.link.valuefield=objCode column.0.link.valueformat=val column.0.linkedname=direct column.0.listsort=string(name) column.0.namekey=name.abbr column.0.querysort=name column.0.shortview=false column.0.stretch=100 column.0.valuefield=name column.0.valueformat=HTML column.0.width=150 column.1.viewalias=assignments column.1.displayname= column.1.linkedname=direct column.1.namekey=assignments column.1.valuefield=assignmentsListString column.1.valueformat=HTML column.1.tile.name=component.assignmentslist column.2.displayname=Actual/ Planned Hours column.2.linkedname=direct column.2.namekey=actualworkrequired column.2.querysort=actualWork column.2.textmode=true column.2.valueexpression=CONCAT({actualWorkRequired}/60,' / ',{workRequired}/60) column.2.valuefield=actualWorkRequired column.2.valueformat=compound column.2.viewalias=actualworkrequired column.3.aggregator.function=SUM column.3.aggregator.valueexpression=SUB({actualWork}, {workRequired}) column.3.aggregator.valueformat=compound column.3.displayname=Hours Variance column.3.linkedname=direct column.3.textmode=true column.3.valueexpression=SUB({actualWork}, {workRequired})/60 column.3.valueformat=customNumberAsString
-
Click Done, then Save View.
